NEW QUESTION 142
Project Scenario - Health and Safety Training Project:
ABC Company is a well-established training company that uses a standard model to develop training materials and deliver courses to customers.
ABC Company has commissioned a project in response to recent changes in government legislation relating to health and safety on construction sites. The project will deliver "capability to provide health and safety training", including the materials needed for classroom-based training and e-learning. The expected benefits for construction companies include a reduction in lost days and legal costs due to accidents.
The e-learning course will be developed by a specialist external consultancy. The materials for classroom-based training will be delivered by ABC Company's development team. All course materials will be piloted before they are used. ABC Company will deliver training to its customers and also hopes to sell the course materials to other training companies as part of their operational business. ABC Company will use their own sales and marketing departments to promote the courses.
The legislation requires construction companies to comply with the new legislation within two years. The course materials and trainers have to be accredited by a government agency before courses can be delivered.
ABC Company is planning to deliver pilot courses within five months of starting the project.

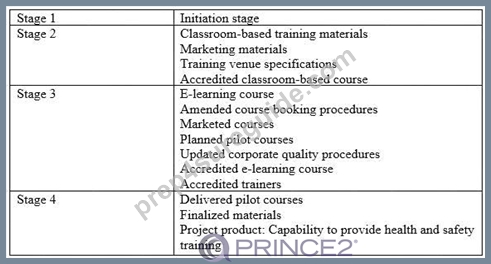

The ABC Company standard development model for new courses recommends the following stages:
End of the Project scenario.
Additional Information:
The Chief Executive Officer (CEO) founded the company five years ago. Under her leadership, ABC Company has grown quickly into a successful training company. It delivers a range of accredited professional training.
The Finance Director is also a founder member of ABC Company and is responsible for authorizing budgets for the Operations and Development Teams. She authorizes all large contracts personally.
The Purchasing Manager reports to the Finance Director and is responsible for managing and monitoring supplier contracts.
The Operations Director is responsible for the delivery off all training and for the training development budget. His department organizes courses, venues and trainers. They work with the Product and the Sales teams to provide a comprehensive training schedule. ABC Company's IT manager reports to the Operations Director.
The Business Development Director has recently been appointed to identify new training needs and propose new products. She will work with the Operations. Director to ensure a cost-conscious approach and that appropriate development technologies are used for the health and safety course.
The Training Development Manager reports to the Business Development Director and is responsible for developing training materials and gaining accreditation, in accordance with the standard course development model. Course developers in his team have skills in a range of development technologies and are allocated to projects as needed.
The Training Delivery Manager, who reports to the Operations Director, is responsible for ensuring that internal and external trainers deliver ABC Company training courses to the required standard. He also checks course materials to ensure they are fit for purpose and of the required quality.
The Central Services Director has responsibility for corporate communications, facilities management and configuration management. He recently led a project to consolidate all company quality systems into one quality management system and set up a corporate quality department, now managed by the Corporate Quality Manager.
The Corporate Document Manager reports to the Central Services Director. She helped establish the company's document management system and now operates it across the business. She manages a team of administrators and contracts staff when workload is high.
The Sales Director joined ABC Company two months ago and is keen to establish himself by suggesting new markets for the courses and material. All account managers and the marketing team report to him. They promote existing training courses to other training companies and existing customers.
End of the additional information.
All the products that are due in stage 3 have been completed, apart from the 'updated corporate quality procedures'. The work has been completed but the product has not yet been approved. The executive has been told that it will be signed off before the end of the project. In response to an exception report, the executive has instructed the project manager to plan to obtain approval of the product in stage 4.
Is this appropriate application of the report management stage end' activity, and why?
- A. No, because approval of the products was planned for stage 3 and must be completed before the stage ends.
- B. Yes, because the completion of the product in the next stage is a follow-on action recommendation for stage 4.
- C. Yes, because approval of the product can be carried forward into the next stage, with authority from the project board.
- D. No, because a project-level exception plan is required before approval of the quality procedures can be delayed.
Answer: C
NEW QUESTION 143
Project Scenario - Health and Safety Training Project:
ABC Company is a well-established training company that uses a standard model to develop training materials and deliver courses to customers.
ABC Company has commissioned a project in response to recent changes in government legislation relating to health and safety on construction sites. The project will deliver "capability to provide health and safety training", including the materials needed for classroom-based training and e-learning. The expected benefits for construction companies include a reduction in lost days and legal costs due to accidents.
The e-learning course will be developed by a specialist external consultancy. The materials for classroom-based training will be delivered by ABC Company's development team. All course materials will be piloted before they are used. ABC Company will deliver training to its customers and also hopes to sell the course materials to other training companies as part of their operational business. ABC Company will use their own sales and marketing departments to promote the courses.
The legislation requires construction companies to comply with the new legislation within two years. The course materials and trainers have to be accredited by a government agency before courses can be delivered.
ABC Company is planning to deliver pilot courses within five months of starting the project.
The ABC Company standard development model for new courses recommends the following stages:
End of the Project scenario.
Additional Information:
The Chief Executive Officer (CEO) founded the company five years ago. Under her leadership, ABC Company has grown quickly into a successful training company. It delivers a range of accredited professional training.
The Finance Director is also a founder member of ABC Company and is responsible for authorizing budgets for the Operations and Development Teams. She authorizes all large contracts personally.
The Purchasing Manager reports to the Finance Director and is responsible for managing and monitoring supplier contracts.
The Operations Director is responsible for the delivery off all training and for the training development budget. His department organizes courses, venues and trainers. They work with the Product and the Sales teams to provide a comprehensive training schedule. ABC Company's IT manager reports to the Operations Director.
The Business Development Director has recently been appointed to identify new training needs and propose new products. She will work with the Operations. Director to ensure a cost-conscious approach and that appropriate development technologies are used for the health and safety course.
The Training Development Manager reports to the Business Development Director and is responsible for developing training materials and gaining accreditation, in accordance with the standard course development model. Course developers in his team have skills in a range of development technologies and are allocated to projects as needed.
The Training Delivery Manager, who reports to the Operations Director, is responsible for ensuring that internal and external trainers deliver ABC Company training courses to the required standard. He also checks course materials to ensure they are fit for purpose and of the required quality.
The Central Services Director has responsibility for corporate communications, facilities management and configuration management. He recently led a project to consolidate all company quality systems into one quality management system and set up a corporate quality department, now managed by the Corporate Quality Manager.
The Corporate Document Manager reports to the Central Services Director. She helped establish the company's document management system and now operates it across the business. She manages a team of administrators and contracts staff when workload is high.
The Sales Director joined ABC Company two months ago and is keen to establish himself by suggesting new markets for the courses and material. All account managers and the marketing team report to him. They promote existing training courses to other training companies and existing customers.
End of the additional information.
Checkpoint reports are being produced monthly. A week after the last checkpoint report was prepared, the team responsible for developing the 'classroom-based training materials' have realized that they will not be able to deliver the materials to the accreditor by the work package completion deadline.
Which action demonstrates application of the 'manage by exception' principle?
- A. The team manager immediately produces an exception plan to replace the current plan.
- B. The team manager immediately reports the issue to the project manager.
- C. The team manager reports the issue in the next checkpoint report.
- D. The team manager raises a risk that the deadline may be missed.
Answer: B
Explanation:
Explanation
Reference
http://prince2.wiki/Manage_by_exception
NEW QUESTION 144
Scenario
Additional Information
Further information on some resources who could be involved in the project:
Outcome Account Manager: He represents Outcome which is a recruitment agency that provides specialist outsourcing resources. Outcome provided the consultants who carried out the feasibility study and the same consultants will be providing support and guidance to the Information Technology and Facilities teams during the project.
Director of Finance Division: She was transferred from the Information Technology Division 12 months ago. She is responsible for ensuring a cost-conscious approach is adopted in all operational and project activities across the Ministry of Food Hygiene.
Hardware Manager: Reports to the Director of Information Technology. He provides computer hardware to all business functions but has little awareness of the needs of his colleagues working in software.
Payroll Manager: Reports to the Director of Finance. He is a very experienced and efficient qualified accountant who has much of the responsibility of running the Finance Division on behalf of the Director of Finance. He has been involved in drafting the Ministry's business strategy and assisting in a full business risk assessment. He also drafted the corporate Business Case standards.
Which 2 alternative actions apply to the proposed Executive for this project?

- A. Replace with 'Payroll Manager' because he is a very experienced and efficient qualified accountant.
- B. Add 'Director of Finance' because she understands the operation of the Information Technology Division and the Facilities Division.
- C. Replace with 'Director of Finance Division' because she can ensure a cost-conscious approach to the project that gives value for money.
- D. Retain because he accepts that outsourcing is the best solution.
- E. Retain because he has the right level of authority to be able to control the strategic nature of the Outsourcing project.
Answer: C,E
NEW QUESTION 145
Which product should register that the risk of a competitor producing a calendar at the same time was identified at the beginning of the project but the assessment of this risk appears to have been poor?
- A. Risk Register
- B. Lessons Report
- C. Issue Register
- D. Follow-on action recommendations
Answer: B
Explanation:
Explanation/Reference:
Question Set 2
NEW QUESTION 146
Scenario
Additional Information
During the initiation stage the Project Manager met with the Marketing Director to find out more about the requirements of the promotional calendar and recorded the following notes:
There has been a reduction in the order numbers at the MNO Manufacturing due in part to the increased marketing activities of its competitors. 10% of customers have not re-ordered in this financial year and staff morale is poor. A number of skilled staff have left as a result and replacement staff have not been recruited due to the reduced operation. If the project is successful, a recruitment campaign will be required to fill the existing staff vacancies and there may be a requirement for additional staff. Operational costs are likely to increase because skilled staff are expensive and difficult to find.
In financial terms, there were a total of 1,500 orders in the last financial year, each with an average profit of
£2k. The Marketing department believes that sending a promotional calendar to our current and prospective customers would increase orders by at least 10% with a minimum of 10 further orders from the list of prospective customers within 12 months from the date of distribution.
The Marketing Director will be funding the project from the business marketing budget. She believes that the effect of a good company image portrayed by a successful calendar would last into a second year. She has forecast the same increase in orders for a second year and predicts that the annual employee satisfaction survey will show a measurable improvement in staff morale.
A number of alternatives were explored, including:
20% discount for all repeat customers - not cost-effective and very short term
A promotional calendar as a free Christmas gift - would target current and prospective customers and
the benefits would last into a second year
A series of television and press advertisements was too expensive
A direct mail shot to all customers - benefit would be short term
Creation of an internet website - would not suit all customers
The calendar is seen as the favored option, as long as the company's competitors do not increase their marketing activity. Whilst the Marketing department wants a very high quality, glossy product, the project management team must be aware of the cost this will incur.
Which 2 statements correctly define a Business Case risk which should be recorded under the Major risks heading?
- A. Operational costs will increase as a result of the recruitment campaign.
- B. If the calendar quality is poor customers will not use it, creating the reverse effect and reducing orders further.
- C. The prepared calendar pack is to be delivered to the printers by the first week in December.
- D. If any competitors launch a calendar at the same time this will reduce the impact of the MNO calendar and benefits will be reduced.
- E. Staff morale will improve as a result of the promotional calendar.
Answer: B,D
NEW QUESTION 147
Additional Information
Chief Executive Officer (CEO): He started the company 25 years ago and knows his job very well. He injured his leg two years ago which has restricted his visits to the engineering area. As CEO he has an overall perspective of the business strategic requirements and the authority to commit resources as required.
Marketing Director: She has been with the company for three years, following a successful career with a publicity company. She has the ability to represent the needs of the business, particularly as this is a marketing project. She has the authority to commit the annual business marketing budget, from which the project will be funded, as she sees appropriate. She will be responsible for monitoring the expected benefits of the calendar, in particular the improvement of the company's image.
Engineering Manager: He has been responsible for many engineering innovations in the company and is still as keen and energetic as the day he started. VVhilst he will not be part of the project team, his staff will feature in the photos for the promotional calendar.
Central Records: This group of five staff looks after all company records and document control. They now maintain all project files.
Bright Lights: This is the local office supplies company. It supplies all the stationery and office equipment needs of the company and will supply the stationery for this project.
Portraits ltd: This is a professional photographic company with a number of excellent photographers and a history of successful work. This company has been selected to take the photos for the company calendar. It has yet be decided which of the photographers to use.
Which 2 statements explain why the Marketing Director should be appointed as a Senior User for this project?
- A. The Marketing department will help to deliver the benefits of this project.
- B. She previously had a successful career in publicity.
- C. A number of the products will be produced by the Sales department and the Marketing department.
- D. She can represent the Marketing department.
- E. The project will be funded from the business marketing budget.
Answer: A,D
NEW QUESTION 148
When does Directing a Project begin?
- A. From the completion of Starting up a Project
- B. From the completion of Initiating a Project
- C. From the beginning of Starting up a Project
- D. From the beginning of Initiating a Project
Answer: A
NEW QUESTION 149
The project is at the end of stage 4. The project manager has changed the benefits management approach. It
now includes all the activities necessary to measure the increased revenue.
Who should approve this update?
- A. Project manager
- B. Project board
- C. Corporate management
- D. Project assurance
Answer: B
Explanation:
Explanation
NEW QUESTION 150
The project board has asked for highlight reports every six weeks during stage 3. As a result, the project manager has asked each team manager for checkpoint reports every six weeks, in order to collate these into the highlight report. The team manager for the 'marketed courses' is new to team management.
Is this an appropriate action as part of the 'controlling a stage' process, and why?
- A. No, because the project board should decide on the frequency and content of progress reporting.
- B. No, because the frequency of reporting should reflect the level of control required for the work package.
- C. Yes, because the project board will need to be updated with the progress of every team.
- D. Yes, because checkpoint reports are a time-driven control providing progress information.
Answer: D
NEW QUESTION 151
Which of the following principles describes this statement?" xxx defines tolerances for each project objective to establish limits of delegated authority"
- A. Focus on products
- B. Manage by stages
- C. Learn from experience
- D. Manage by exception
Answer: D
NEW QUESTION 152
Which of the following is the definition for an off-specification?
- A. An issue the Project Manager needs to resolve or escalate
- B. Something forecast or currently not meeting specification
- C. A proposal for a change to a baseline
- D. A statement of concern
Answer: B
NEW QUESTION 153
Which statement applies to the Introduction section?
- A. Delete entry 3 because it is the Project Manager's responsibility to implement the Quality Management Strategy.
- B. Delete entry 2 because this is the Project Manager's responsibility.
- C. Delete entry 1 because the project approach is defined in the Project Brief.
- D. Move entry 3 to the Roles and responsibilities section because this is a quality responsibility.
Answer: D
Explanation:
Explanation/Reference:
NEW QUESTION 154
Using the Project Scenario and the Extract from Stage Plan for stage 3 provided as additional intonation for this question in the Scenario Booklet, answer the following 5 questions.
The Stage Plan for stage 3 has been produced.
The Engineering Manager insists that there are to be no interruptions to operations whilst photographs are being taken of the engineering staff performing their everyday duties and operating machinery. Two weeks ago the professional photographer produced the photo session schedule based on the operational staff schedule.
The operational staff schedule is produced weekly and maintained by the Engineering Manager.
None of the E500 change budget has been used to date and this is available for the stage.

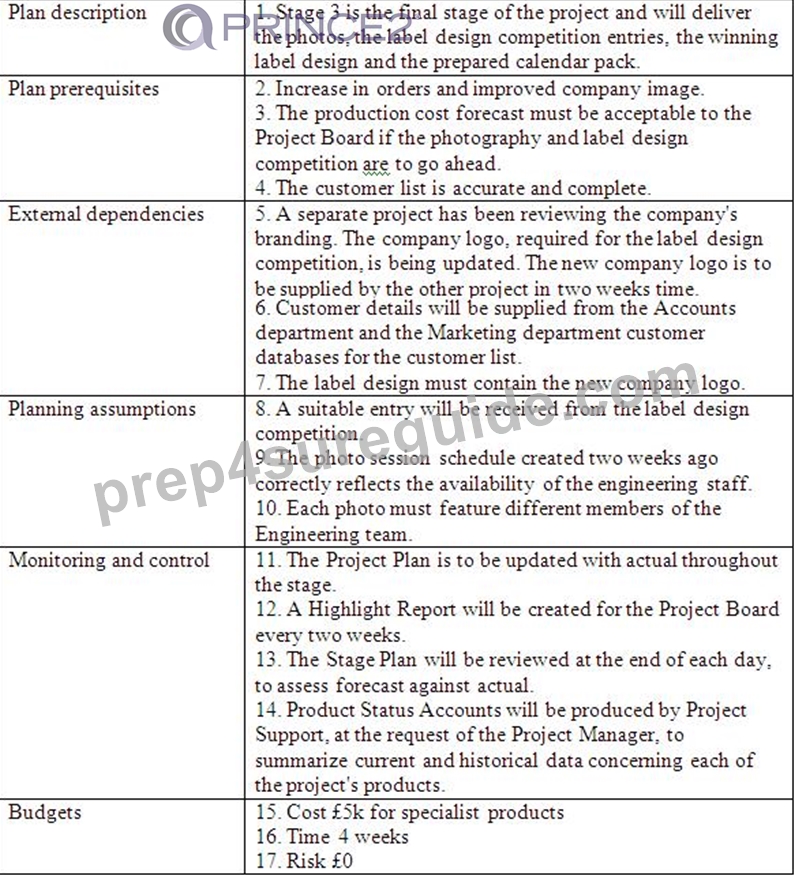

Which 2 statements apply to the External dependencies section?
- A. Delete entry 5 because the new company logo is being delivered by a separate project and will be detailed in the plans for that project.
- B. Delete entry 7 because it should be shown in the Product Description for the label design.
- C. Delete entry 6 because the customer details were used in stage 2 to create the customer list.
- D. Move entry 5 to Plan description because the new company logo will be delivered during stage 3.
- E. Move entry 5 to Plan prerequisites because the new company logo will influence the label designs.
Answer: B,C
NEW QUESTION 155
This question provides a number of changes which may or may not be required to the Extract from the Communication Management Strategy provided in the additional information.
What statement applies to the Records section?
- A. Move entry 8 to Tools and techniques because it refers to a filing technique.
- B. Move entry 7 to Communication procedure because it refers to the method to be used for communication to external parties.
- C. Move entry 6 to the Configuration Management Strategy because it defines the identification scheme for the project's products.
Answer: C
NEW QUESTION 156
Which of the following reports does not contain any information on risk?
- A. Highlight report
- B. Lessons Report
- C. End Stage Report
- D. Issue Report
Answer: D
NEW QUESTION 157
Which of the following is not a factor to consider when determining the length of a stage?
- A. The amount of resources available h the short term
- B. The technical stages within the project
- C. The amount of risk associated with the project
- D. How far ahead you can sensibly plan n detail
Answer: A
NEW QUESTION 158
Scenario
Product Summary
A list of customers will be collated. This will use existing information from the Accounts department about current customers, and existing information from the Marketing department about prospective customers.
Using the tariff of mailing costs available from the Post Office, a production cost forecast will be produced to allow the CEO and the Marketing Director to decide whether to continue with the project. If they decide to continue, they will give the approval to launch the internal label design competition. Competition rules will be required to communicate details of the competition to the staff. The chosen label design will then be selected from the competition entries.
The photos for the calendar must be based on existing photo design ideas available from the Marketing department. The selected photos will be chosen from these. Monthly calendar displays will be created to show the required layout of each page.

Product Breakdown Structure (contains errors)
Extract from Stage Plan for stage 3.
(All entries are true statements but may not be shown under the correct heading or in the correct document).
Using the Project Scenario and the Extract from Stage Plan for stage 3 provided as additional intonation for this question in the Scenario Booklet, answer the following 5 questions.
The Stage Plan for stage 3 has been produced.
The Engineering Manager insists that there are to be no interruptions to operations whilst photographs are being taken of the engineering staff performing their everyday duties and operating machinery. Two weeks ago the professional photographer produced the photo session schedule based on the operational staff schedule. The operational staff schedule is produced weekly and maintained by the Engineering Manager.
None of the £500 change budget has been used to date and this is available for the stage.
Which 2 statements apply to the Monitoring and control section?
- A. Delete entry 14 because the Product Status Account is NOT an ad-hoc report. It is produced at the end of each stage to identify any variations between planned status, reported status and actual status of the stage's products.
- B. No change to entry 12 because this describes how the Project Board will control the stage. ~
- C. Delete entry 11 because this relates to the monitoring and controlling of the Project Plan, not the Stage Plan.
- D. Delete entry 13 because this is part of the Controlling a Stage process.
- E. Move entry 12 because the Highlight Reports are deliverables of this stage and should be shown under Product descriptions.
Answer: B,C
NEW QUESTION 159
During the 'create the project plan' activity as part of the initiation stage, the project manager identifies several threats to the project timescales. These threats relate to stage 3 products. Therefore, the project manager decides to wait until the end of stage 2 to assess the risks to the project plan.
Is this an appropriate application of the plans theme, and why?
- A. Yes, because risk planning should take place in the stage plan before the risks occur, not in the project plan.
- B. Yes, because detailed planning of stage 3 should take place after completion of the stage 2 products.
- C. No, because the risk actions to manage project-level threats should be recorded in the risk register.
- D. No, because the risks inherent in the project plan should be assessed, and the plan modified to manage them.
Answer: D
Explanation:
Explanation/Reference: https://books.google.com.pk/books?id=CSm7x74Px94C&pg=PA181&lpg=PA181&dq=prince2
+risks+inherent+in+the+project+plan+should+be+assessed,+and+the+plan+modified+to+manage
+them&source=bl&ots=wY57bkzn3M&sig=ACfU3U2SjvwFX9KajLooA41PHyOT8-
nHAA&hl=en&sa=X&ved=2ahUKEwjwk9b1ybnhAhWhMewKHWLwCQYQ6AEwCXoECAgQAQ#v=onepage&q
=prince2%20risks%20inherent%20in%20the%20project%20plan%20should%20be%20assessed%2C%20and
%20the%20plan%20modified%20to%20manage%20them&f=false
NEW QUESTION 160
Which of the following principles describes this statement?
"xxx defines tolerances for each project objective to establish limits of delegated authority"
- A. Focus on products
- B. Manage by stages
- C. Learn from experience
- D. Manage by exception
Answer: D
Explanation:
Explanation/Reference:
Question Set 1
NEW QUESTION 161
Which 2 alternative actions apply to the proposed Executive for this project?
- A. Replace with 'Director of Finance Division' because she can ensure a cost-conscious approach to the
project that gives value for money. - B. Replace with 'Payroll Manager' because he is a very experienced and efficient qualified accountant.
- C. Add 'Director of Finance' because she understands the operation of the Information Technology Division
and the Facilities Division. - D. Retain because he accepts that outsourcing is the best solution.
- E. Retain because he has the right level of authority to be able to control the strategic nature of the
Outsourcing project.
Answer: A,E
NEW QUESTION 162
Which of the following represents the four key characteristics a good Project board should display?
- A. Authority, Credibility, Commitment, Availability
- B. Authority, Credibility, Delegation, Availability
- C. Authority, Availability, Connections, Delegation
- D. Authority, Credibility, Connections, Delegation
Answer: B
NEW QUESTION 163
The executive has set the following tolerances for stage 2:
Time (+/- 1 week)
Cost (+/- £20,000)
Scope (using MoSCoW prioritization technique)
Risk (based on the risk appetite defined in the risk management approach) These tolerances have been recorded in the stage plan. The project manager will report progress regularly via highlight reports to the project board and use exception reports to raise exceptions. In addition, the project assurance role will monitor the stage to provide confidence to the project board that exceptions are being reported.
How well does this apply the 'manage by exception' principle, and why?
- A. It applies the principle well, because the project manager needs to control the project using discrete management stages.
- B. It applies the principle poorly, because tolerances should be set for each stage against each of the six aspects of project performance.
- C. It applies the principle well, because tolerances should be set for the related aspects of project performance for each stage.
- D. It applies the principle poorly, because it is the regular reporting of progress that should give the project board the required confidence.
Answer: B
NEW QUESTION 164
Although it is not specified in the current corporate branding standards, the MFH corporate logo should be shown on the front page of the service level agreement.
- A. Raise an issue (request for change).
- B. Raise an issue (off-specification).
- C. Accept this error as a concession.
- D. Obtain agreement from the Director of Facilities Division to amend this within the remaining +2 days tolerance.
Answer: A
NEW QUESTION 165
What will be the impact on the benefits?
- A. An additional cost of £1.5m to deliver the services provided by the Facilities Division.
- B. Reduced savings, now £10m over 10 years.
- C. Outsourcing project cost reduced by 50%.
- D. Increased savings of £5m over 10 years from the new initiative to centralize the services provided by the Facilities Division.
Answer: B
Explanation:
Explanation/Reference:
Question Set 2
NEW QUESTION 166
......
Who should take the PRINCE2-Practitioner Certified Exam
This certification is aimed at project managers, aspiring project managers, and anyone who manages projects. It is also relevant to other key staff involved in the design, development, and delivery of projects, including Project Board members (e.g., Senior Responsible Owners), Team Managers (e.g., Product Delivery Managers), Project Assurance (e.g., Business Change Analysts), Project Support (e.g. Project and Program Office personnel) and operational line managers/staff.
For more info read reference:
PRINCE2-Practitioner Exam Source
PRINCE2-Practitioner Exam Dumps PDF Guaranteed Success with Accurate & Updated Questions: https://www.prep4sureguide.com/PRINCE2-Practitioner-prep4sure-exam-guide.html
Pass PRINCE2-Practitioner Exam - Real Test Engine PDF with 285 Questions: https://drive.google.com/open?id=1bXkQy7f8F2PX81xQgue41mRAf01qPPPn
